Kitchen remodel in progress in DuPage County showing cabinet installation before countertop templating

Kitchen Remodeling

How Long Does a Kitchen Remodel Take? A Phase-by-Phase Timeline

By Jason Neu | Owner & Licensed General Contractor

Published April 2026 | Updated April 2026

How Long Does a Full Kitchen Remodel Take?

A full kitchen remodel in DuPage County takes 6 to 14 weeks from demolition to final walkthrough, plus 4 to 8 weeks of pre-construction (design, material selection, permitting, and material lead times) before demolition starts. Total timeline from first consultation to a finished kitchen: typically 10 to 22 weeks, or roughly 3 to 5 months.

Those ranges are wide because "kitchen remodel" covers three very different scopes of work. A cosmetic refresh takes 3 to 5 weeks. A mid-range renovation with new cabinetry and layout tweaks takes 6 to 10 weeks. A full gut renovation with layout changes, structural modifications, and custom cabinetry takes 10 to 14 weeks or more. The scope determines the timeline. Anyone who quotes you a single number without asking about your scope is guessing.

This guide walks you through every phase of a real DuPage County kitchen remodel: what happens, how long it takes, what the homeowner is responsible for, and the specific things that speed up or slow down each phase. It is written by a licensed general contractor who has managed kitchen projects from Villa Park tract homes to Hinsdale estates.

The Two Big Mistakes Homeowners Make About Kitchen Remodel Timing

Before the phase breakdown, two mistakes worth avoiding.

Mistake 1: Thinking the remodel starts at demolition

It does not. The remodel starts the day you call a contractor. The 4 to 8 weeks of pre-construction (design, material selection, permitting, ordering) are as important as the construction phase. A homeowner who calls a contractor in April and expects demo to start in May is setting up the project for rushed decisions and supply chain problems.

Mistake 2: Thinking "6 weeks" means 6 calendar weeks

Construction timelines assume working days. A 6-week construction timeline is 30 working days, which typically lands on the calendar as 7 to 8 actual weeks once you account for weekends, holidays, and inspection scheduling. National cost guides that quote "6 to 12 weeks" are describing working weeks, not wall-clock weeks.

Now here is what actually happens, phase by phase.

The 11 Phases of a DuPage County Kitchen Remodel

Phase 1: Consultation and Scope Definition (1 to 2 Weeks)

This is where the project begins. A homeowner calls, emails, or fills out a contact form. The contractor visits the home, walks the kitchen, measures, listens, and assesses the existing conditions (framing, plumbing, electrical, HVAC, structural).

At LuxeLine, Jason Neu personally conducts every consultation. The site visit typically takes 60 to 90 minutes. Within 24 hours, the homeowner receives a written scope outline, a ballpark budget range, a proposed timeline, and Jason's direct phone number.

What happens: On-site consultation with measurements and condition assessment. Discussion of the homeowner's goals, use patterns, and priorities. Initial budget conversation. Written follow-up within 24 hours covering scope, budget range, and proposed timeline.

What the homeowner does: Schedule the consultation. Show the kitchen. Explain what is working and what is not. Ask questions. Review the written follow-up.

What can extend this phase: Comparing multiple contractors. Consultations with three qualified contractors typically take 1 to 2 weeks to schedule and complete. Do not rush this decision.

Phase 2: Design and Material Selection (2 to 4 Weeks)

Once you select a contractor, the design phase begins. This is where the layout is finalized, materials are selected, and the specifications that will drive ordering and construction are locked in.

What happens: Layout finalization (whether to remove a wall, add an island, reposition the sink, or reconfigure the workflow). Cabinetry selection (door style, finish, hardware, interior organization). Countertop selection (material, color, edge profile). Backsplash selection (tile or stone, pattern, grout color). Flooring selection (material, color, pattern). Lighting plan (general, task, accent, and under-cabinet layers). Appliance selection (if replacing, including ventilation requirements). Fixture selection (faucet, sink, pot filler). Paint colors. Hardware.

Why this phase cannot be rushed: Every decision made in this phase affects what gets ordered, when it arrives, and how construction sequences. A homeowner who changes their cabinet door style three weeks into construction has just added 4 to 8 weeks to the project because cabinetry lead times reset.

What the homeowner does: This is the phase with the highest homeowner involvement. Expect to visit tile and stone showrooms, review cabinetry samples, coordinate with appliance specifications, and make a large number of decisions in a compressed period.

What can extend this phase: Indecision on cabinetry is the most common cause. Custom cabinetry orders require final drawings, which require final dimensions, which require final layout decisions.

Phase 3: Permitting and Material Lead Times (2 to 6 Weeks)

Permits are pulled and materials are ordered. Most of this phase happens in parallel, which compresses the total elapsed time.

Permitting

Kitchen remodels involving electrical, plumbing, structural, or HVAC changes require permits in every DuPage County municipality. LuxeLine handles all permitting as part of the project. Permit turnaround varies by municipality.

  • Schaumburg: 1 to 2 weeks
  • Naperville: 2 to 3 weeks
  • Hinsdale: 3 to 4 weeks (architectural review)
  • Villa Park, Lombard, Oak Brook, Elmhurst: 1 to 3 weeks

Cabinetry Lead Times

This is the single longest lead-time item in most kitchen remodels and the one that drives the total project timeline.

  • Stock cabinetry: 2 to 3 weeks from order to delivery
  • Semi-custom cabinetry: 4 to 6 weeks
  • Custom cabinetry: 8 to 12 weeks, sometimes longer

Countertop Templating

Countertop fabrication cannot start until cabinets are installed because the template is cut from the actual installed cabinet boxes. Natural stone and quartzite fabrication: 2 to 3 weeks after templating. Engineered quartz: 1 to 2 weeks after templating.

Phase 4: Demolition and Rough-In (1 to 2 Weeks)

This is where the construction phase begins. The existing kitchen is removed. Plumbing, electrical, and HVAC rough-ins are completed to support the new layout.

Demolition (2 to 4 days)

Removing existing cabinets, countertops, tile, flooring, drywall (if needed), and the sink. Disconnecting plumbing and electrical. Hauling away debris. Protecting the rest of the home.

Discovery

This is the moment when older DuPage County homes reveal what is behind the walls. Galvanized plumbing, outdated electrical, deteriorated framing. We budget discovery time into every project.

Rough-In Plumbing

New supply lines, new drain lines, new pot filler line (if applicable), new gas line location for the range.

Rough-In Electrical

New circuits for the kitchen (dedicated circuits for range, refrigerator, dishwasher, microwave, disposal, and counter outlets). New wiring for lighting.

First Milestone Approval: The homeowner reviews the rough-in work before drywall closes it up. This is where the homeowner walks through the space with Jason, confirms the locations of all plumbing and electrical points, and signs off before the next phase begins.

Phase 5: Drywall, Flooring Prep, and Paint (1 to 2 Weeks)

With rough-in inspection passed, the walls close up and the surfaces prepare for the finish work.

Drywall

Hang, tape, mud, and sand. Three coats of compound with sanding between each for a smooth finish. This alone takes 5 to 7 working days because of drying time between coats.

Flooring Prep

If hardwood or tile is being installed, the subfloor is evaluated and corrected. High spots ground down. Low spots self-leveled. Old flooring fully removed.

Primary Paint

Walls and ceiling painted. Trim painted. The room should look mostly finished from a color standpoint before cabinets and appliances go in because cabinet installation damages fresh paint far more than paint touches up cabinet edges.

Phase 6: Flooring Installation (3 to 7 Days)

Hardwood, porcelain tile, luxury vinyl, or engineered flooring installed. Under most circumstances, flooring is installed before cabinetry so that cabinets can sit on finished floor.

Hardwood

Acclimation period (3 to 5 days for site-finished). Installation (1 to 3 days). Sanding and finishing for site-finished floors (2 to 3 days).

Porcelain Tile

Underlayment installation. Tile installation with appropriate pattern. Grout cure time (24 hours minimum before heavy foot traffic).

Luxury Vinyl Plank

The fastest flooring option. Installation completes in 1 to 2 days with no cure time.

Tip: Confirm tile layout and grout color against a dry-laid sample before installation. A tile that looked fine in a 6-inch sample can read very differently across 200 square feet.

Phase 7: Cabinet Installation (3 to 7 Days)

This is the most visible phase. The cabinets that were ordered 4 to 12 weeks earlier arrive and get installed.

Base Cabinet Installation (1 to 2 days)

Base cabinets set, leveled, shimmed, and screwed to the wall. Lower cabinets always go in first.

Upper Cabinet Installation (1 to 2 days)

Uppers mounted, leveled across runs, and aligned to the base cabinet fronts.

Tall Cabinet Installation (1 day)

Pantry and appliance cabinets set.

Trim and Filler (1 to 2 days)

Crown molding, scribe molding, toe-kick trim, and filler pieces installed.

Second Milestone Approval: The homeowner walks the installed cabinetry with Jason. Cabinet placement, door alignment, hardware pre-installation locations, and any inconsistencies are identified before the next phase. Nothing proceeds to countertop templating until the homeowner signs off on the cabinet installation.

Planning a kitchen remodel in DuPage County?

Jason Neu walks every client through the milestone approval process so nothing moves forward without your sign-off. See how we work.

Learn About Our Process

Phase 8: Countertop Templating, Fabrication, and Installation (2 to 3 Weeks)

This phase is the pressure point in every kitchen remodel. It cannot start until cabinets are installed. It has to complete before plumbing, appliances, or backsplash can be finished. And it takes 2 to 3 weeks of actual calendar time.

Templating (1 day)

The countertop fabricator creates a full-scale template of the cabinet tops. The template captures every cabinet footprint, every sink cutout, every appliance cutout, and every wall condition.

Fabrication (1 to 2 weeks)

For engineered quartz: 5 to 7 working days. For natural stone (marble, quartzite, granite): 7 to 14 working days because of slab cutting, edge profiling, and sealing.

Installation (1 day)

Fabricated countertops delivered and installed. Sinks set. Edge seams joined and polished. Silicone seal around the perimeter.

Why this phase extends kitchens: The sequence dependency is absolute. Cabinets must be fully installed before templating. Sink must be purchased before templating. Faucet must be specified before templating. Any delay in any of these inputs pushes the entire schedule.

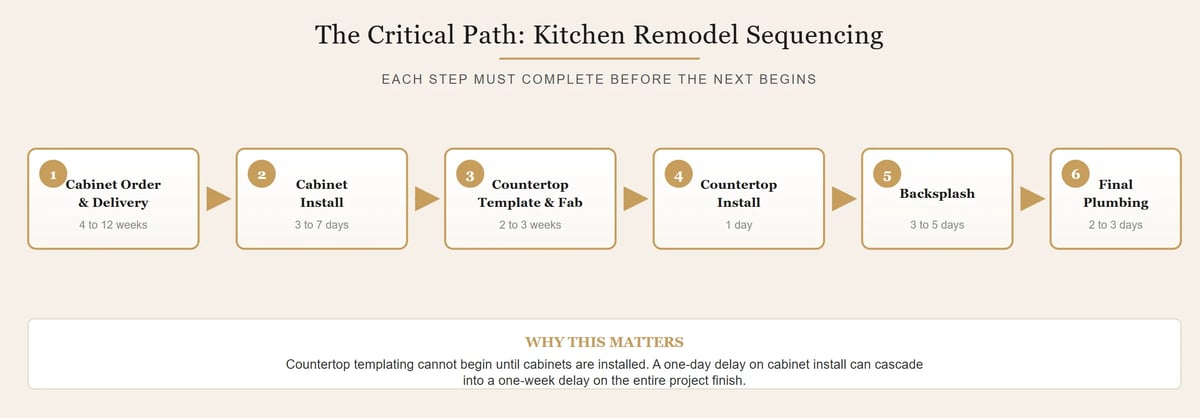

Critical path flow diagram showing six sequential steps in a DuPage County kitchen remodel: cabinet order and delivery (4 to 12 weeks), cabinet install (3 to 7 days), countertop template and fabrication (2 to 3 weeks), countertop install (1 day), backsplash (3 to 5 days), and final plumbing (2 to 3 days). Each step must complete before the next begins.
The Critical Path: Each phase blocks the next. A one-day delay on cabinet installation cascades into a one-week delay on the finished kitchen.

Phase 9: Backsplash Installation (3 to 5 Days)

With countertops installed, the backsplash can be tiled to its final dimension against the finished countertop.

Layout and planning (1 day): Tile is laid out dry against the actual wall to confirm pattern, cuts, and alignment. Any adjustments to reduce awkward cuts or maintain symmetry.

Tile installation (1 to 2 days): Tile mortared to the wall in the planned pattern.

Grouting (1 day): Grout applied, wiped, and cleaned. 24 hour cure before any cleaning products or wall-mounted items.

Sealing: If natural stone or porous tile, sealer applied after grout cure.

Phase 10: Final Electrical, Plumbing, and Appliance Installation (3 to 7 Days)

The last major phase before final walkthrough.

Final plumbing: Sink plumbing connected. Dishwasher water and drain connected. Refrigerator water line connected. Garbage disposal installed. Faucet set and tested.

Final electrical: All outlets trimmed out. All switches installed. Recessed lighting and pendants installed and tested. Under-cabinet lighting installed. Dimmers calibrated.

Appliance installation: Range, wall oven, cooktop, hood, microwave, dishwasher, refrigerator delivered, installed, and tested. Gas appliance connections inspected. Ventilation verified.

Final inspection: Municipal inspector returns to sign off on the finished electrical, plumbing, and completed kitchen.

Third Milestone Approval: The homeowner tests every outlet, every switch, every faucet, and every appliance. Anything that does not meet spec is documented and corrected.

Phase 11: Final Walkthrough and Punch List (1 to 3 Days)

The kitchen is essentially complete. The final walkthrough is the systematic review of every element.

Systematic inspection: Every cabinet door checked for alignment and soft-close function. Every drawer opened and closed. Every countertop surface inspected for flaws. Every grout line checked for consistency. Every light fixture tested.

Punch list corrections: Any items identified during the walkthrough are documented and corrected within 2 to 5 days.

Final cleanup: Construction dust removed. Cabinets and counters cleaned. Floors swept and mopped. Protection materials removed.

Final Milestone Approval: The homeowner signs off on the completed kitchen after all punch list items are corrected. When the homeowner signs off, the project is complete. The 24-month workmanship guarantee begins at this moment.

The Milestone Approval Process: Why LuxeLine Projects Stay On Schedule

Most remodeling companies manage timelines by pushing forward. The faster we finish, the sooner we start the next job.

LuxeLine manages timelines by stopping at each phase boundary.

Here is why that actually saves time.

Problems caught at their natural phase boundary are cheap to fix. Problems that get buried under the next phase are expensive and time-consuming to correct. A cabinet installation that is a half-inch off during phase 7 is a simple adjustment. The same installation problem discovered during phase 8 (countertop templating) means the countertops have to be templated around a flaw, and the flaw is permanent.

LuxeLine's milestone approvals prevent this by building four explicit sign-off points into every kitchen project:

Approval 1

After Rough-In, Before Drywall

Homeowner walks the space, confirms all plumbing and electrical positions, and signs off before drywall closes the walls.

Approval 2

After Cabinet Installation

Homeowner walks the installed cabinetry, confirms alignment and placement, and signs off before countertops are templated.

Approval 3

After Final Installation

Homeowner tests every fixture, outlet, and appliance and documents anything needing correction.

Approval 4

Final Walkthrough

Homeowner signs off after all punch list items are corrected. The 24-month workmanship guarantee begins at this point.

Learn more about how we manage projects

Total Timeline by Project Type

Cosmetic Refresh: 3 to 5 Weeks Construction

Total: 7 to 10 weeks from consultation to completion

Scope: Replace cabinetry (no layout changes). Replace countertops. Replace flooring. Fresh paint. New fixtures and hardware. No plumbing or electrical relocations.

3-5 weeks

Pre-Construction

3-5 weeks

Construction

7-10 weeks

Total

Mid-Range Renovation: 6 to 10 Weeks Construction

Total: 11 to 18 weeks from consultation to completion

Scope: New custom or semi-custom cabinetry. New countertops. New flooring. Layout tweaks (relocate sink, add island, change appliance positions). New electrical and plumbing rough-in for relocated fixtures.

5-8 weeks

Pre-Construction

6-10 weeks

Construction

11-18 weeks

Total

Full Gut Renovation: 10 to 14 Weeks Construction

Total: 16 to 24 weeks from consultation to completion

Scope: Complete reconfiguration. Wall removal. New HVAC runs. Full custom cabinetry. Premium countertops. Luxury appliance integration. New flooring.

6-10 weeks

Pre-Construction

10-14 weeks

Construction

16-24 weeks

Total

What Extends Kitchen Remodel Timelines in DuPage County Specifically

National cost guides list generic delay causes. Here are the ones that actually matter in DuPage County.

Custom cabinetry lead times with local suppliers

DuPage County homeowners frequently select custom cabinetry from local cabinetmakers. Lead times can range from 8 to 16 weeks depending on the shop's current workload. During peak remodeling season (March through October), lead times extend. Ordering in January or February, before the spring rush, can shave 3 to 6 weeks off the pre-construction phase.

Municipal permitting differences

Hinsdale's architectural review process adds time to any project involving exterior modifications. Naperville's dual-county jurisdiction (DuPage and Will) can affect permit routing depending on which side of the county line the home sits on. Villa Park and Lombard generally have faster permitting than larger municipalities.

Older home discovery

Homes built before 1975 often have galvanized supply lines, cast iron drains, and undersized electrical panels. When the walls open during demo, these conditions are often worse than they appeared. Replacement adds 3 to 7 days to the rough-in phase.

Appliance delivery for professional-grade brands

Wolf, Sub-Zero, and Thermador appliances that DuPage County homeowners commonly select have longer lead times than standard brands. A 6-burner range that needs 8 weeks to arrive should be ordered 10 weeks before demolition, not during pre-construction.

Homeowner decision speed

The biggest variable. A homeowner who can make design and material decisions in days instead of weeks saves 2 to 6 weeks on the total project. A homeowner who is still debating cabinet finishes three weeks into construction pushes the entire schedule.

Frequently Asked Questions

Ready to Start Your Kitchen Remodel?

Every week you delay is a week you spend in the kitchen you do not love.

Schedule a free consultation with Jason Neu, owner and licensed general contractor. He will visit your DuPage County home, assess your kitchen, walk through your goals, and give you a written scope of work, a realistic budget range, and a specific timeline for your project. No pressure. No obligation.

Schedule Your Free Consultation

Or call Jason directly: 773-771-9245
